Most companies get the custom software development cost wrong before the project even starts. They collect a few quotes, anchor on the headline number, and sign a contract without accounting for QA, cloud infrastructure, or what ongoing maintenance actually costs year two.
This article breaks down where the budget actually goes in 2026: by project size, build phase, and region. By the end, you will know how to read a vendor quote, what to budget beyond the build, and what variables in your own project will move the number up or down.
Table of Contents
Key Takeaways
- Project size drives the baseline: an MVP or internal tool and an enterprise system sit in very different budget tiers.
- Phase allocation matters more than total cost: where the budget goes across development, QA and DevOps shows whether a vendor is cutting corners.
- Team location changes the rate, not the work: wherever the developers sit, the project still needs the same QA, design and project management.
- Hidden costs cause most overruns: maintenance, compliance, cloud hosting and AI integration are often left out of the first quote.
- Vendor selection should follow scope clarity: the right pricing model depends on how well-defined your requirements are before you start.
Further Reading
What custom software development actually costs in 2026
There is no single price for custom software in 2026. Cost follows scope, team size and how long the build runs, so a focused MVP and an enterprise system sit in very different budget tiers.
The table below shows how project size usually maps to the kind of product and the build time.
| Project Size | Examples | Typical Timeline |
|---|---|---|
| Small | MVP, internal tool, basic web app | About 3 – 4 months |
| Medium | Custom CRM, SaaS platform, e-commerce with advanced logic | About 5 – 9 months |
| Large | ERP, enterprise SaaS, AI-enabled platform | About 9 – 18 months or more |
The tier that catches most buyers off guard is the medium one. A “simple” custom CRM or a multi-platform mobile app with third-party integrations grows quickly once QA, data migration and deployment are included. A quote that looks much lower than the others often leaves out one of those phases.
Why small projects often run over their initial quote
For example, picture an inventory tool quoted as a small project. If the quote leaves out QA, data migration from the old spreadsheets and deployment, the final cost can end up at two or three times the first number.
Leaving those phases out is not wrong in itself. The problem starts when the exclusions are not written into the contract, and the client finds out mid-project that they are paying for work they thought was included. A low headline number on a fixed-price quote is usually a scoping problem, not a pricing one.
How the budget breaks down across build phases
Custom software cost does not sit in a single line item. The split across phases shows whether a vendor’s quote reflects real delivery or a race-to-the-bottom proposal.
In a typical project, the budget splits roughly like this:
| Build Phase | Typical Budget Share | What it covers |
|---|---|---|
| Core development | 40% – 60% | Backend and frontend engineering, API development, integrations |
| QA and testing | 15% – 25% | Automated and manual testing, security checks, performance testing |
| UI/UX design | 10% – 15% | Wireframes, interactive prototypes, visual interface design |
| Project management | 10% – 15% | Sprint planning, stakeholder reporting, scope and risk management |
| Deployment and DevOps | 5% – 10% | Cloud infrastructure setup, CI/CD pipeline, go-live support |
CI/CD pipeline: An automated system for testing and deploying code after each build cycle. For production software, this means bugs get caught before they reach end users, and releases ship predictably rather than in risky batches.
When a vendor’s quote allocates less than 15% to QA on a medium-complexity project, that is a flag. Either QA is being handled by developers doubling up (which creates blind spots) or it is being skipped and treated as a post-launch fix. Both paths cost more later.
How developer location affects custom software cost
Where your developers sit changes the hourly rate more than any other single choice. It does not change how much work the project needs. A well-run team in Vietnam, Eastern Europe or your own city still needs the same QA, design and project management, so compare quotes on scope and team structure first, and on rate second.
Vietnam has a large engineering workforce, concentrated in Ho Chi Minh City and Hanoi. Engineers in React, Node.js, Python, Java and .NET are readily available, and many global companies have built long-term delivery teams here.
For a company in Singapore, Australia or the US running a multi-month build, a lower rate adds up over the length of the project. Whether the saving is real depends on how the engagement is run: clear scope, a regular review cadence and a named owner for quality. A team in Vietnam also overlaps most of the Australian working day and almost all of Singapore’s.
The objection we hear most often: “We’ve tried offshore before and got burned on communication.” That is almost never a location problem. It is a process problem. Teams that fail offshore typically failed at scope definition, escalation paths and sprint review discipline, not because the developers were in the wrong time zone.

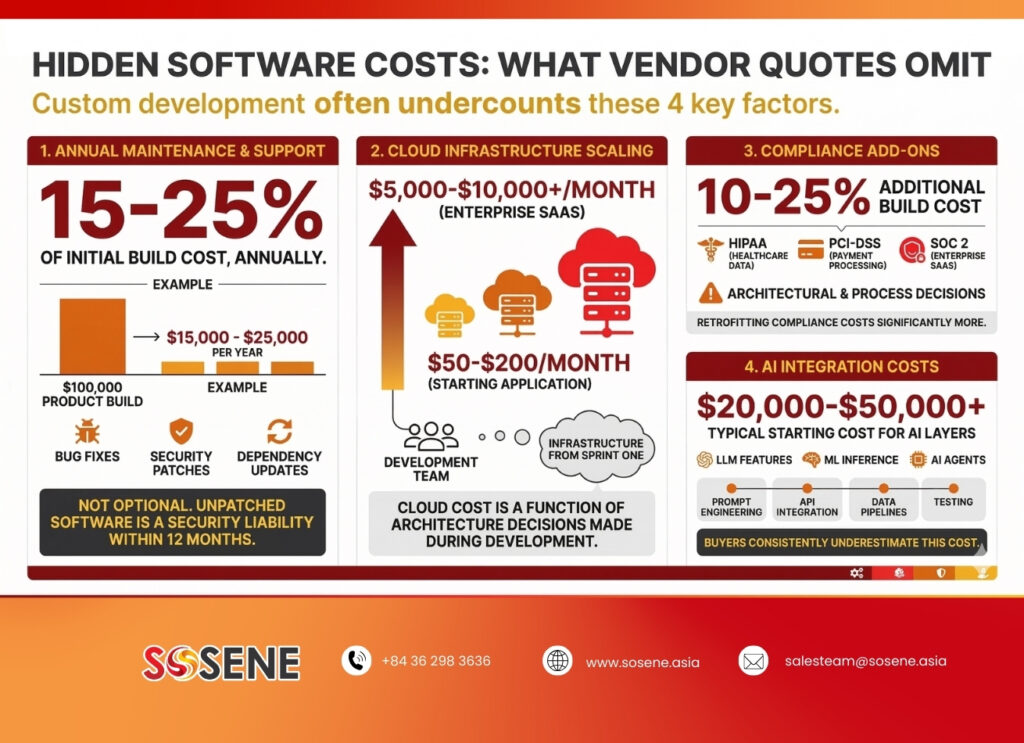

Hidden costs that most vendor quotes omit
Custom software cost does not stop at launch. The costs that most often surprise buyers come after it, and they repeat every year.
Maintenance and support covers bug fixes, security patches and dependency updates. This is not optional: software that is not patched becomes a security risk. Budget for it as a yearly cost, not a one-off.
Cloud infrastructure scales with usage. A small internal app costs little to host; a platform with heavy traffic costs far more. Cloud cost is largely decided by architecture choices made during development, so the team should be thinking about infrastructure from the first sprint.
Compliance requirements add work when they apply. HIPAA for healthcare data, PCI-DSS for payment processing and SOC 2 for enterprise SaaS all call for specific design and process decisions. Adding compliance after launch costs more than building it in from the start.
AI integration has become a common line item. LLM features, machine learning inference or an AI agent layer need prompt design, API integration (OpenAI, Gemini, Anthropic), data pipelines and testing. Buyers who treat AI as a “quick add-on” usually underestimate it, so plan it as its own workstream.
“The year after launch always has costs: maintenance, cloud hosting and new features. We build them into the initial roadmap, so they are not a surprise at month thirteen.”
Sosene Team
What pricing model should you use for your project
The right pricing model for your build depends on how clearly defined your requirements are before you sign.
Fixed-price works when the scope is locked: feature list, acceptance criteria, and timeline are agreed before work starts. It gives you budget certainty but limits flexibility. Any scope change triggers a change order. This model suits well-defined internal tools, MVPs with a clear feature set, and phase-one builds where the goal is to validate a specific assumption.
Time and materials (T&M) is appropriate when the scope will evolve. You pay for actual hours worked and resources used, with agreed hourly rates per role. This model suits product companies building iteratively, or enterprise clients whose requirements surface progressively across discovery. The tradeoff: cost is less predictable upfront, but you are not locked into a scope that no longer reflects reality by month three.
Dedicated team means a fixed group of developers, a QA engineer, and typically a project manager, assigned exclusively to your project at a monthly rate. This model suits multi-month or multi-year builds where ongoing development, support, and feature velocity matter more than per-deliverable billing. It is the default model for SaaS companies and enterprises running continuous product development.
The mistake most first-time buyers make is choosing fixed-price for a project with unclear scope, then watching it collapse into change orders. The better question before selecting a model is: how much do you actually know about what you are building?
What do I need to know to estimate my custom software development cost accurately?
Accurate budgeting for custom software development requires clarity on four variables before you speak to a single vendor.
First, define your project scope at the feature level, not the concept level. “A platform for managing field technicians” is a concept. A list of specific features with user roles, integrations and data flows is a scope. Vendors can only give you a reliable number when they can see the latter.
Second, identify your compliance requirements upfront. If your product will handle health records, financial transactions or personal data at scale, the regulatory layer is a cost driver that must be factored in from the start. Discovering HIPAA or PCI-DSS requirements after the architecture is set will cost more to address than if they were specified in the brief.
Third, account for the full delivery team, not just developers. A project that quotes for “five developers” but omits a QA engineer, a designer and a project manager is quoting for part of a delivery team. The rest of those roles will appear somewhere in the final bill.
Fourth, keep a contingency in the budget. Discovery reveals complexity. Integrations are harder than documented. Third-party APIs change. A contingency is not pessimism; it reflects how software projects actually run.
Buyers who work through these four points before vendor conversations find that quotes cluster more tightly and scope disputes become rare. The preparation shifts the negotiation from “what does this cost?” to “are we aligned on what we’re building?”
How Sosene approaches custom software development
Sosene’s software development engagements start with a scoping phase before a single line of code is written. For most new clients, this means a structured discovery process that produces a feature specification, a delivery timeline and a budget breakdown across build, QA and deployment. That document becomes the foundation for the contract.
From there, we offer a fixed price when the scope is well defined, or monthly time and materials with an optional cap when it will evolve. Either way, clients know what they are getting before they commit. Scope surprises mid-project are one of the most common reasons outsourced projects go over budget.
For clients who need AI integration in their product, we treat it as a first-class engineering workstream, not an afterthought. LLM integration, automation workflows and AI agent development are handled by engineers who specialize in those layers, not general developers adapting as they go.
If you are scoping a custom software project and want a clear-eyed view of what it will cost given your requirements, the software development page outlines how we structure engagements and what information we need to give you an accurate number.
Conclusion
The most important decision you face before budgeting a custom software project is not which vendor to choose. It is whether your scope is defined clearly enough to get a quote that means anything.
There is no single answer to what custom software costs in 2026. The figure that matters is the one that reflects your actual requirements, your compliance obligations, your ongoing infrastructure needs and the full delivery team. Headline quotes that leave out those variables are not useful for planning.
Start with scope clarity. Then evaluate vendors on their ability to hold that scope and deliver against it. If you want to see how Sosene structures a scoping process for your type of project, contact us!
FAQs
How much does custom software development cost in 2026?
There is no single price. Cost depends on scope, complexity, team size, build duration and developer location. A focused MVP sits in a much lower budget tier than an enterprise system, and a medium-complexity SaaS platform or CRM sits in between once QA, deployment and project management are included. The reliable way to get a number is a scoped estimate based on your feature list.
What is included in a custom software development cost estimate?
A complete estimate covers five phases: core development (40–60% of budget), QA and testing (15–25%), UI/UX design (10–15%), project management (10–15%), and deployment and DevOps (5–10%). Estimates that omit QA or DevOps are incomplete and will produce surprises after launch.
Is Vietnam a good option for custom software development?
Vietnam has a large pool of engineers in React, Node.js, Python, Java and .NET, mostly in Ho Chi Minh City and Hanoi, and hourly rates are lower than in North America, Western Europe or Australia. A team in Vietnam also overlaps most of the Australian working day and almost all of Singapore’s. As with any location, results depend on clear scope, regular sprint reviews and a named owner for quality.
What hidden costs should I budget for beyond the initial build?
The items most often left out are annual maintenance and support (bug fixes, security patches, dependency updates), cloud hosting that grows with usage, compliance work such as HIPAA or PCI-DSS, and AI integration for LLM or machine learning features. Ask each vendor whether their quote covers each of them.
Which pricing model is right for my custom software project?
Fixed-price works when requirements are fully defined before work starts. Time and materials suits projects where scope will evolve iteratively. A dedicated team model is best for multi-month or ongoing builds where you need sustained engineering velocity. The right model depends on how clearly you can specify what you need before the first sprint begins.
